The Failures Tracker

The cost, the years, and the agencies between you and a permit.

Everything below is sourced. Where a number isn't published, we say so. Where we propose a fairer one, it's labeled proposed. Nothing on this page is invented to make a point — the system is plenty damming on its own.

17

Active CA leases

$250K

Danger-zone $

15mo

Danger-zone time

Exhibit A

The real cost of a permit.

Every bar is a real published or interview-sourced cost range, drawn to the same dollar scale.

Solid = floor (cheapest plausible cost) · faded = ceiling (worst-case total).
Danger zone = past ~$250K, more than most small CA farms can scrape together. Any bar whose ceiling crosses the dashed line spills into it.
Icons flag risk: manageable · stretches budget · usually fatal.
past what a small farm can spend →Danger zone · > $250K
Small-farm starting capital$50K floor$250K ceiling
FloorCeiling

Typical co-op / family operation. [est. — range from grower interviews]

Agency application fees (sum)$5K floor$25K ceiling

CDFW + SLC + RWQCB + USACE filing fees. [est. — many fees not published]

Biological & site surveys$25K floor$120K ceiling
Ceiling

Eelgrass, benthic, marine mammal, water quality baselines.

CEQA consultant fees$60K floor$250K ceiling
FloorCeiling

Required to assemble the EIR document itself.

Full EIR (consultants + surveys + agency)exits budget$150K floor$500K ceiling
FloorCeiling

The all-in cost of getting a single new lease through CEQA.

$0
$100K
$250K
$500K

The EIR bar — the rightmost monster — is what kills most small projects before they ever reach the water.

Exhibit B

The real timeline.

Each bar is months of waiting. The dashed line is the runway most small farms have on day one — about 15 months.

past what a small farm can wait →Danger zone · > 15 mo
Small ag business runway1 yr 3 mo

What a typical small farm can survive on starting capital.

Gear modification approval1 yr

Even minor changes to existing infrastructure.

Species change on existing leasepast runway3 yr 6 mo

Switching from one shellfish or seaweed species to another.

Lease renewalpast runway2 yr

On an already-operating lease.

New bottom lease (open ocean)past runway8 yr

5–10+ years is normal. Some applications outlast the applicant.

1 yr
2 yr
4 yr
6 yr
8 yr

Exhibit C

The Gauntlet.

  • State
  • Federal
  • Local
  • Tribal

Every CA agency a typical new open-ocean shellfish or seaweed farm interacts with. Most of these run in serial, not parallel. Some can't begin until others end. None of them know what the others have asked for.

  1. 01
    CDFWState

    Lease + species authorization

    Wait 12–36 moFee $1.5K–$10K
  2. 02
    California Coastal CommissionState

    Coastal development permit

    Wait 12–24 moFee $2K–$15K
  3. 03
    State Lands CommissionState

    Tidelands / bottom lease

    Wait 12–24 moFee $1K–$8K + rent
  4. 04
    RWQCBState

    Water quality (401 cert)

    Wait 6–18 moFee $500–$5K
  5. 05
    USACEFederal

    Section 10 / 404 federal permit

    Wait 12–36 moFee Free–$100
  6. 06
    NOAA / NMFSFederal

    ESA & MMPA consultation

    Wait 6–24 moFee Free
  7. 07
    CDPHState

    Shellfish sanitation (if applicable)

    Wait 3–9 moFee $1K–$5K
  8. 08
    Local countyLocal

    Use permit / harbor district approval

    Wait 3–12 moFee Varies widely
  9. 09
    Tribal consultationTribal

    AB 52 / SB 18 where triggered

    Wait 3–12 moFee
  10. 10
    CDFAState

    Aquaculture registration

    Wait 1–3 moFee $500

Many of these fee ranges are estimated from public schedules + practitioner reports. Where ranges aren't published, the EIR Wizard proposes small-business-friendly defaults clearly labeled "proposed."

Exhibit B — The CDFW four-phase process

Approved by the Commission · 8/23/2023

The four phases between you and a water bottom lease.

This is the official Fish & Game Commission flow for new state water bottom aquaculture leases — including the Public Interest Determination added in 2023. Phases run sequentially. Permit Reef tracks where a real application sits in the flow and what's stalling it.

  1. 0Phase 0

    Enhanced pre-application

    Prospective applicant contacts CDFW Aquaculture Coordinator. Pre-application consultation, project design, informal consultation with agencies of jurisdiction.

  2. 1Phase 1

    Initial vetting & scoping

    Bottom Lease Application submitted to CFGC. Requirements review by staff. CSLC & CDPH consultation. 90-day public notice if requirements met. MRC + Tribal Committee discussion scheduled.

  3. 2Phase 2

    In-depth analysis

    CEQA Initial Study; EIR or Negative Declaration. Social/economic considerations analysis. Public Interest Considerations evaluation. Tribal consultation. Agency partner comments.

  4. 3Phase 3

    Commission decision

    CFGC receives CEQA document, public interest analysis, and recommendations. Three discretionary actions in one meeting: CEQA certification · public interest determination · lease decision. Approved lease proceeds to other agencies.

Source: California Fish & Game Commission — Figures Displaying Steps in the Enhanced Process for Applications for New State Water Bottom Leases for Aquaculture (approved 8/23/2023). Full document on the Resources page.

CDFW Figure 1 — Aquaculture Lease Application Process, Phases 0 through 3. Full overview flowchart from Phase 0 (pre-application) through Phase 3 (Commission decision) showing CDFW, CFGC, MRC/TC swim-lanes plus public comment and interagency coordination bars.
Figure 1. Aquaculture Lease Application Process, Phases 0–3 (overview).Click to open full-size.

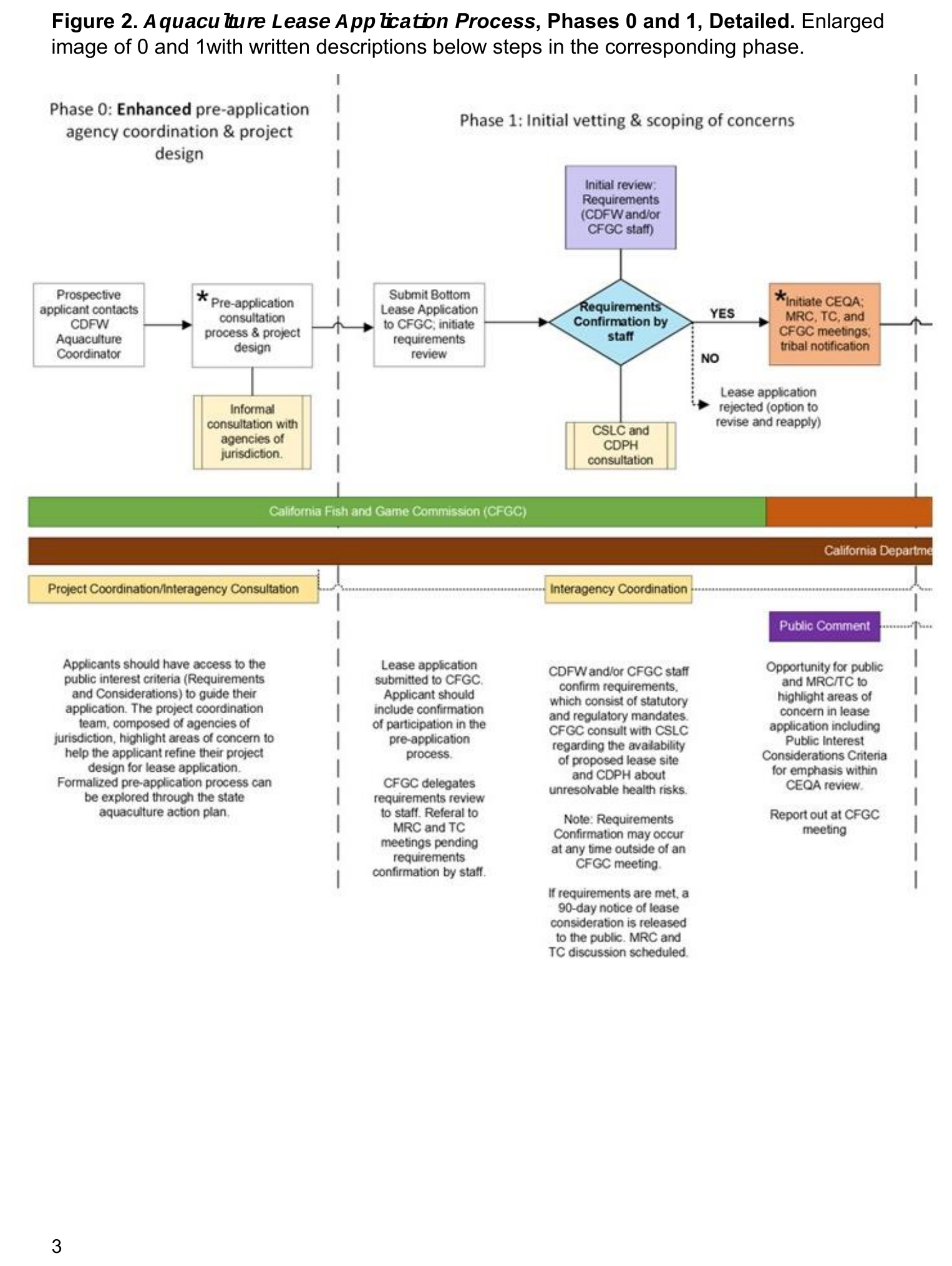

CDFW Figure 2 — Phases 0 and 1 detailed. Pre-application consultation, lease application submission, requirements confirmation, CSLC and CDPH consultation, and initiation of CEQA/MRC/TC meetings with tribal notification.
Figure 2. Phases 0 & 1 — pre-application + initial vetting (detailed).

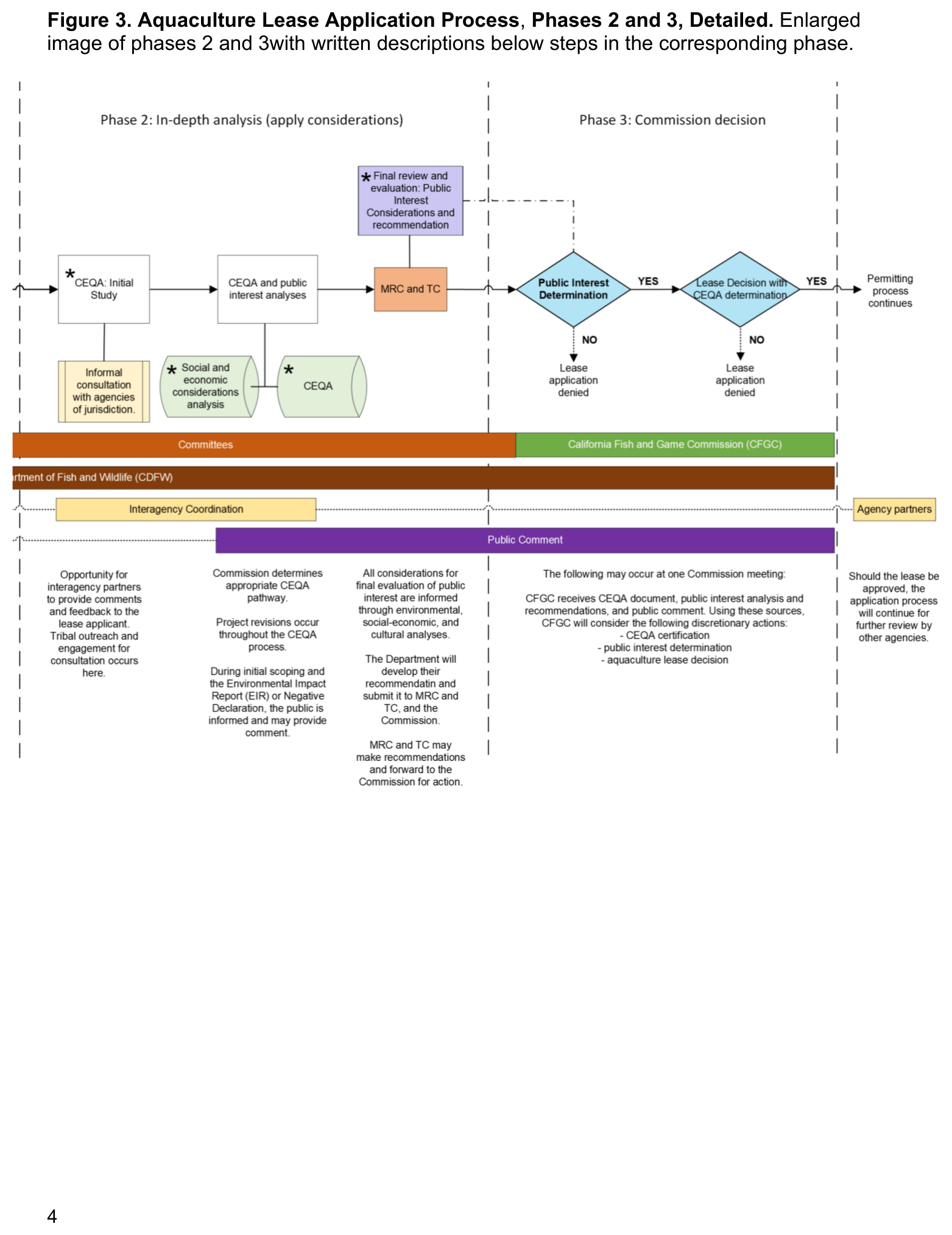

CDFW Figure 3 — Phases 2 and 3 detailed. CEQA Initial Study, social/economic considerations analysis, MRC/TC review, Public Interest Determination, and the final lease decision with CEQA determination by the Commission.
Figure 3. Phases 2 & 3 — CEQA, Public Interest Determination, lease decision (detailed).

Figures reproduced from the CFGC-approved process document (8/23/2023). Tagged real-data.

Exhibit C·b — Federal precedent

NOAA's Aquaculture Opportunity Areas.

NOAA's PEIS-adjacent process produced Atlas / AOA identification reports for the Southern California Bight — the closest thing the U.S. has to a programmatic siting layer. Useful precedent. Imperfect model. We surface it here so growers and agencies can see what already exists at the federal level before California writes its own.

Read our full read on the NOAA precedent →
ProcessNOAA WCR Final PEIS · signed 9/10/2025 by NMFS West Coast RAreal-data
Selected alternativeAlternative 4b · all types of aquaculture · Santa Barbara Channel + Santa Monica Bayreal-data
Species framingFinfish, shellfish, macroalgae — not shellfish/seaweed-firstreal-data
Tiered review for small farmsNot in scope · programmatic, but no small-farm carve-outreal-data
What CA should adoptPre-screened siting atlas · shared baseline · transparent suitabilityproposed
What CA should addShellfish/seaweed-first scope · small-farm tier · tribal co-managementproposed

Source: NOAA WCR AOA Final PEIS & Decision Document (PEIS-006-48-1WC-1728044280). Local mirrors on the Resources page.

Featured pathThe shortcut that already exists

Humboldt Bay is, for now, the one open door.

Coast Seafoods runs an active sublease program in Humboldt Bay where new growers can lease space inside an existing master lease — skipping the multi-year, six-figure new-lease gauntlet entirely. San Diego Bay has limited equivalent paths. The rest of California's coast does not.

The EIR Wizard surfaces these sublease-eligible zones automatically when you pick a location.

K

Surfaced in partnership with

Kelpful Coalition

The advocacy group organizing growers, scientists, and policy folks around CA aquaculture reform. Learn more →

Sublease vs. new lease

Timeline
3–9 mo
60–120 mo
Up-front cost
< $10K
$150K–$500K+
CEQA EIR required
Usually no
Yes, almost always
Risk for small farm
Survivable
Existential

Where we actually are

Progress, no spin.

We will not paper over how early this is. Every counter below is the truth, updated as the database grows.

10/11

Agencies mapped

4/24

Public datasets ingested

18/many

Permit forms catalogued

0/1

EIR templates accepted by an agency
